How Homeowner Decisions Affect a Custom Home’s Construction Timeline

Eric Brown Updated
A white custom kitchen with a long stone-topped island, two pendant lights centered over it, a built-in microwave drawer, and a wall oven in the adjoining pantry.

Homeowner selections affect a custom home’s construction timeline because they determine when materials can be ordered, how framing and early trade work are coordinated, and when trades can complete their work. Finalizing selections early helps prevent avoidable delays throughout the build.

One of the most misunderstood parts of building a custom home is why selections need to be finalized so far ahead of installation.

The lighting may not go in until near the end of construction. Why do we need to select it before framing is finished?

The cabinets are months away from installation. Why do we need to start working on them as soon as the contract is signed?

And if we are waiting on one thing, why can’t we simply move on to something else?

These are reasonable questions. Most homeowners have never managed the construction of a custom home. They see individual selections. As the builder, I have to see how those selections affect the work around them—and the work that comes next.

A custom home is built in a sequence. Selection deadlines are part of that construction schedule.

At Everett Custom Homes, my preference is to have every selection finalized before construction begins. That gives us the best opportunity to price accurately, order early, coordinate the trades, and keep the house moving efficiently.

That is not how every project starts. But understanding why those decisions matter can make the process much easier for everyone involved.

Why does construction need to happen in a particular order?

Construction follows a sequence because one trade’s work often establishes the dimensions, access, support, or finished surfaces that the next trade needs. Changing that order can create extra work or compromise the result.

I have worked for other builders, and I have friends who are builders. Although our methods and individual details may vary, most of us follow a similar overall construction sequence.

There are practical reasons for that.

Framing establishes where things can go. Electrical, plumbing, and mechanical work have to be coordinated before walls and ceilings are closed. Later, cabinets, trim, paint, and other finishes have their own relationships.

Some work can happen at the same time. We look for those opportunities. But other work depends on something being completed first.

Moving a trade ahead simply to show activity does not help if that work has to be removed, repaired, or repeated later.

The goal is steady progress in the right order.

A homeowner once asked me why we could not install the closets before painting. It was a reasonable question. The closet systems were substantial, and getting them installed would have looked like progress.

But those systems did not have backs. The painted room walls would be the visible backs of the finished closets.

Our typical sequence is to prime before cabinets are installed, complete the trim and cabinet installation, and then paint the house. We want the closet walls painted before the backless closet systems go in. The painter has full access to the walls and can produce a cleaner result without working around shelves, dividers, and hanging sections.

We still return for touch-ups and repaint affected areas where needed. But that is different from leaving an entire wall to be painted around a completed closet system.

There was a reason for the order, even though it was not obvious from the homeowner’s perspective. Many construction decisions work that way. One step prepares the house for the next.

The closets could still be selected, approved, and ordered early. Waiting for the correct installation stage does not mean waiting to make the selection.

Drawings ready for review are not the same as an approved order ready for production.

What are rough-ins in home construction?

Rough-ins are the installation of plumbing, electrical, HVAC, and low-voltage systems before insulation and drywall conceal the work inside walls and ceilings. They establish the connections and pathways that finished fixtures and equipment will use.

Think about what is inside the walls of a completed house:

  • Plumbing: Water-supply pipes, drainage and sewer piping, and plumbing vents.
  • Electrical: Wires, outlet and switch boxes, and connections for lighting and equipment.
  • HVAC: Ductwork, refrigerant lines, condensate drains, and related components.
  • Low voltage and networking: Ethernet and other network wiring, television connections, security cameras, and home-automation wiring where included.
  • Whole-home audio: Speaker wiring and planned audio zones for systems such as Sonos Zone Players or Bluesound Nodes.
  • Lighting control: Pre-wiring for systems such as Control4, lighting-control keypads, dimmers, touchscreens, and related equipment.

The lights, faucets, and other visible finishes may be installed much later. But the work behind them needs to be coordinated now.

We also need to consider blocking or backing for items that will mount to the walls. That is framing preparation rather than a mechanical or electrical rough-in, but it belongs in the same planning conversation before drywall.

Once the walls and ceilings are closed, changing a location or adding a connection can mean opening finished surfaces and repeating work.

Do whole-home audio, Control4, and lighting-control systems need to be pre-wired?

Whole-home audio, Control4, lighting-control systems, and other low-voltage systems need to be planned and wired before insulation and drywall close the walls and ceilings.

During rough-ins, we also run speaker wiring around the home. Many of our homes have extensive whole-home audio, using Sonos Zone Players or Bluesound Nodes. Speaker locations, audio zones, equipment locations, and pathways back to the equipment need to be considered while the walls are open.

The same applies to Control4 and lighting-control systems. Keypads, touchscreens, dimmers, lighting-control modules, equipment racks, and other components may require wiring, power, network connections, or backing in locations that are difficult to add later.

The exact brand or equipment can sometimes be finalized later, but the infrastructure cannot be an afterthought. The system may be installed at the end of construction, but the wiring plan belongs in the rough-in stage.

Should homeowners make every selection before construction starts?

Homeowners should finalize as many selections as possible before construction starts. Early selections give the builder more time to confirm pricing, coordinate installation requirements, and order materials before they become urgent.

That is my preference on every custom home.

In my experience, homeowners often have roughly 60 percent of their selections completed when we begin. That is my estimate from the projects we work on.

Appliances are usually easier. People often know what they want. Other selections may have details we can settle early and finish choices we can resolve later, provided those later decisions still meet ordering deadlines.

Lighting and tile tend to take longer. In my experience, tile is rarely finalized before we start. Homeowners want to see options, compare materials, and feel comfortable with how everything will work together.

I understand that. These are choices they will live with for years.

If a selection remains open, however, it still needs a deadline that reflects the construction schedule. The question becomes: when do we need this decision so the work can continue?

Early selections also strengthen the budget. As I explain in How a Custom Home Budget Actually Works, a defined product and quantity allow us to obtain actual pricing instead of continuing to carry an allowance.

Why do appliances, lighting, and plumbing fixtures need to be selected before framing is finished?

At Everett Custom Homes, we want appliances, lighting, and plumbing fixtures selected before framing is completed so their exact locations, dimensions, support, utility connections, and installation requirements can be coordinated before rough-ins begin.

Lighting is a good example of a finish selection that affects construction much earlier than people expect.

A fixture may need to center over a kitchen island, a vanity, or a particular feature in the room. Once we know the actual fixture and exact location, we can identify whether framing interferes with that placement or whether additional support is needed.

Any necessary framing adjustments must be coordinated appropriately, including engineering where required. The time to identify those conflicts is while the structure is accessible.

General lighting plans do not always resolve every one of these details. Unless a lighting designer has developed a detailed plan for the house, there is often additional coordination to do with the actual selections.

Appliances create similar requirements. The selected models affect cabinet dimensions, electrical connections, gas connections, water connections, plumbing locations, ventilation, and clearances.

Many appliances have unusually precise connection requirements. Electrical, gas, and water connections may need to land within a defined area relative to the appliance, the cabinetry, and the finished wall. A refrigerator, range, wall oven, or dishwasher is not simply connected wherever it is convenient; the model’s installation instructions tell us where those connections need to be.

Plumbing fixtures also need to be selected early. We want the plumber working from the actual fixture selections and installation requirements when coordinating the rough-in locations. The fixtures may not be installed until much later, but the decisions that affect the plumbing behind the walls need to be made before that work begins.

When the electrician and plumber begin their rough-ins, they need usable information. Knowing that there will be “a refrigerator somewhere on this wall” is different from knowing the model and the coordinated cabinet layout.

When should cabinet planning begin?

Cabinet planning should begin as soon as the contract is signed because cabinet layouts and integrated lighting affect framing, appliance placement, electrical work, and plumbing long before the cabinets are installed.

Cabinets are also a long-lead item, so we need to allow time for design, revisions, approval, fabrication, and delivery.

The color may not need to be finalized at the first meeting. The layout needs attention immediately.

Where is the sink? Which appliances are being used? Where do the cabinets begin and end? How does the island relate to the lighting above it and the plumbing below it?

Those answers help other trades do their work correctly.

Cabinet lighting is another reason to start early. There are some very good options now, including LED tape lighting that fits into channels within the cabinetry. Those details need to be part of the cabinet design and electrical planning.

The cabinet maker and electrician need to coordinate where the lighting will go, how wiring will reach it, and where the necessary power supplies and controls will be located. It is much easier to plan those details while the cabinetry is being designed and the walls are still open.

A selection can have more than one deadline. We may need the cabinet layout settled for rough-ins while a finish choice remains open until the supplier’s production deadline. That flexibility has to be coordinated with the cabinet supplier; it cannot be assumed.

When should fireplaces be selected for a custom home?

Fireplaces should be selected early enough to coordinate the framing opening, venting route, and required clearances before framing is completed. At Everett, we typically install the fireplace units right after framing.

A fireplace is another item homeowners may associate with the finished room. But the unit itself and its installation requirements affect the work much earlier.

We need the actual model selected so the framing and venting can be planned around the manufacturer’s requirements. Required clearances need to be incorporated into the design rather than discovered after the surrounding structure is built.

The decorative finish may come later. The fireplace selection cannot wait until then.

Why should Ethernet and Wi-Fi locations be planned before drywall?

Network connections and Wi-Fi access-point locations should be planned before drywall so the wiring can be installed while walls and ceilings are accessible. Ethernet can serve devices directly and connect compatible mesh units or access points through a wired backbone.

I still believe Ethernet is one of the most worthwhile things to install in a new home. I like to run it wherever we can reasonably anticipate needing a connection. With the walls open, it is relatively inexpensive compared with trying to add those runs after the home is finished.

Home offices, television locations, and planned Wi-Fi access points deserve attention during the low-voltage planning. We should be thinking about how the homeowner will use the network throughout the house.

My wife works in digital infrastructure, and she puts it this way: “The best Wi-Fi starts with the best Ethernet.”

That may sound contradictory, but the wireless devices still benefit when the equipment providing Wi-Fi has a reliable wired connection back to the network.

Ethernet backhaul means using network cable to connect compatible mesh units back through the network instead of relying on a wireless link between them. As eero explains in its guide to Ethernet backhaul, that wired connection can reduce congestion and make performance more consistent.

Good placement and the right equipment still matter. The construction decision is to give the network the wiring and locations it needs before the walls are closed.

What do we need to know about flooring early in construction?

The early flooring requirement is its thickness, because the finished floor height affects transitions and adjoining construction. The hardwood species does not have to be finalized to establish that dimension.

If we are using three-quarter-inch site-finished hardwood, that gives us a thickness to coordinate around. If we are using an engineered product, we need to know its specified thickness.

At that stage, I am concerned with the dimension the other work depends on. A later species or finish choice still needs to meet the supplier’s ordering deadline, and any change in thickness needs to be discussed before it affects work already completed.

This is another example of why it helps to separate the construction decision from the appearance decision. We may have some flexibility on one while needing a firm answer on the other.

Why do patio stone and masonry stair treads need to be selected so early?

Patio stone and masonry stair treads need to be selected before the adjoining masonry elevations are established because the stone thickness, setting bed, and drainage slope affect how the finished surfaces meet.

This is one of the selections that surprises homeowners most.

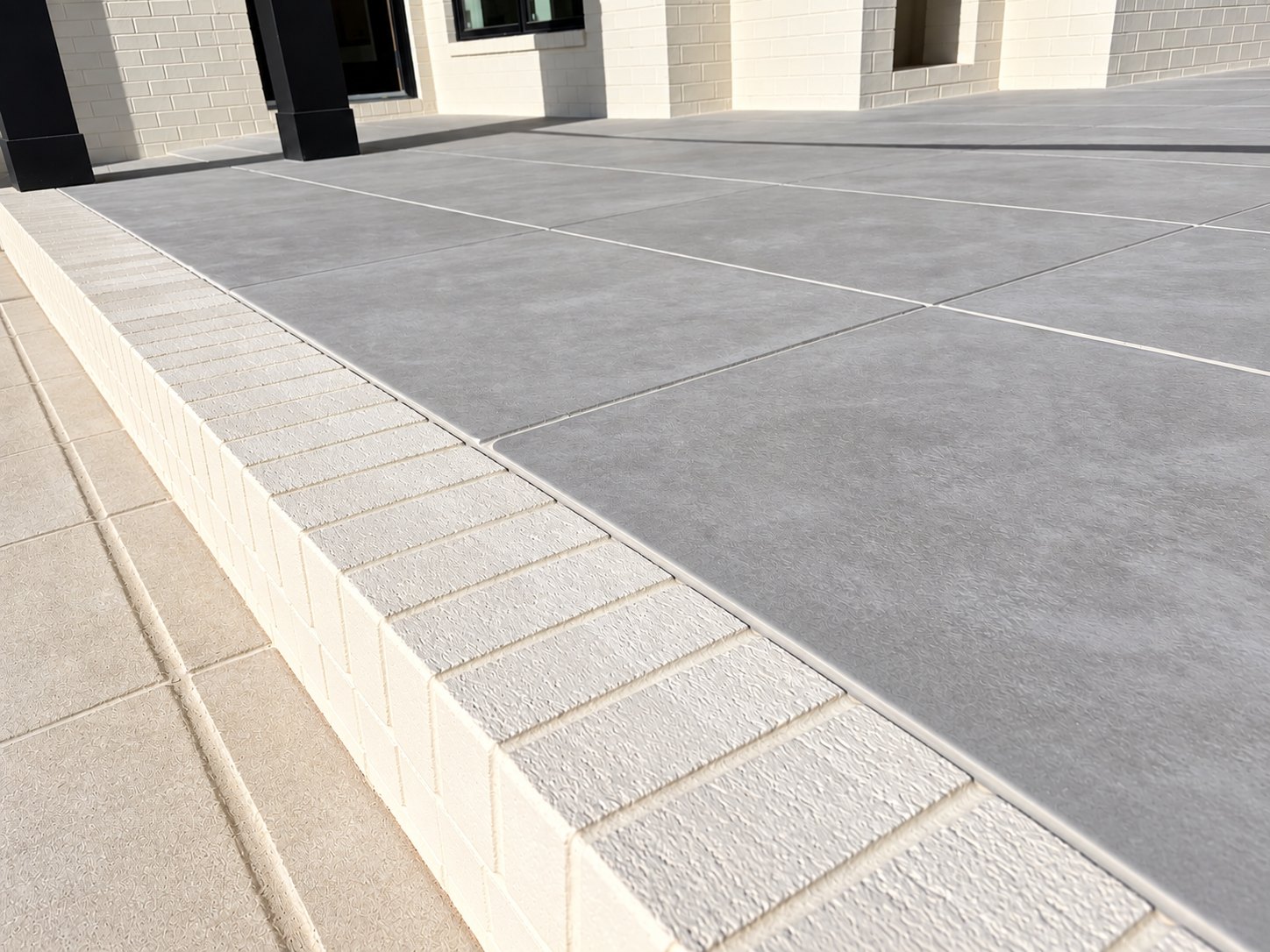

A finished elevated patio where large gray pavers meet a cream brick rowlock edge, beside light brick walls and black porch columns.

Many of our homes have elevated masonry patios and masonry stairs. On a brick home, the stone may need to meet a brick rowlock. Similar coordination can come up around an outdoor kitchen and its adjoining patio.

Before the mason establishes those heights, we need to know the thickness of the actual stone being used. We also need to allow for the thinset or mortar bed beneath it, depending on the installation.

The finished elevation includes both. Selecting a different thickness later can change how the stone meets the brick and how the adjoining work needs to be built.

When I say we want the surfaces to meet flush, I do not mean the patio should be completely level. The patio still needs to slope away from the house for drainage. We are coordinating a clean transition between materials while preserving that slope.

Stair-tread thickness also affects the finished stair elevations. These dimensions need to be resolved as part of the masonry work, rather than left until the stone is ready to install.

This is the connection I want homeowners to understand: the finish material determines part of the construction underneath and beside it. A selection that looks decorative can be a construction decision needed much earlier.

Why do we order materials before the house is ready for them?

Ordering early allows time for products to be ready before installation is due. Our appliance and lighting vendors build the orders and hold the products for us until we are ready for delivery.

We finalize and order windows during pre-construction, before framing starts. The window package needs to be settled early so we can coordinate the openings and allow time for delivery.

I like to get the appliance and lighting orders moving early. Our vendors build those orders and hold the products for us, then coordinate delivery when we are ready. We do not need to wait until installation is approaching to get the order underway.

Depending on the item, materials may take two, four, six, or eight weeks to arrive. Some take longer. The supplier’s current lead time is what matters for the specific order.

Making a decision does not make the material immediately available.

Approval may still need to be followed by order processing, production, shipping, delivery coordination, and installation scheduling.

How do we determine when a selection is due?

A custom-home selection deadline is set by working backward from installation and any earlier work that depends on the decision, allowing time for approvals, ordering, supplier lead times, delivery, and scheduling.

The basic calculation is:

Installation date minus supplier lead time minus delivery and scheduling buffer equals the latest order date.

Selection and approval need to happen before that order date. For items that affect framing or rough-ins, the design decision may be needed even earlier.

Here is a simplified homeowner guide. Exact dates depend on the house, supplier, and construction schedule.

Item Decision timing at Everett What the decision affects
Windows Finalize and order during pre-construction, before framing starts Ordering, opening coordination, and delivery planning
Cabinet layout and integrated lighting Begin at contract signing; resolve before affected framing and rough-ins Appliance fit, plumbing, wiring, lighting channels, and cabinet production
Appliances Select early and finalize before framing is complete Exact cabinet, electrical, gas, water, plumbing, ventilation, clearance, and procurement requirements
Lighting Select early and finalize before framing is complete Exact placement, support, framing coordination, and electrical rough-in
Plumbing fixtures Select early and finalize before framing is complete Fixture locations, installation requirements, and plumbing rough-in coordination
Fireplaces Select before framing is complete; units typically installed just after framing Framing openings, venting routes, and manufacturer-required clearances
Ethernet, audio, and home-control wiring Coordinate before rough-ins and finalize before drywall Network wiring, Wi-Fi access points, speaker locations, audio zones, Control4, lighting controls, television, security, and equipment connections
Flooring Confirm flooring thickness early, before work that depends on finished floor elevations Floor heights and transitions; the hardwood species does not need to be finalized for this coordination
Tile Finalize by the project-specific deadline, before any affected preparation and ordering Product availability, layout, installation details, and tile scheduling
Exterior patio stone and masonry stair treads Before adjoining masonry elevations are established Stone and setting-bed thickness, flush brick transitions, stair elevations, and drainage slope
Interior trim Finalize before its material-ordering and installation deadlines Procurement, finish details, and trim scheduling
Closets Approve designs before production and installation deadlines Fabrication, delivery, and installation after wall painting
Changes to planned spaces or scope Resolve during design when possible; review later changes before proceeding Affected construction, new materials, trade sequencing, budget, and completion date

What happens when a selection misses its deadline?

A late selection can delay ordering, cause a missed installation window, and affect dependent trades. Its schedule impact may be longer than the time spent making the decision.

Trades have commitments to other projects. If the material is unavailable when an installer is scheduled, we may lose that window. Once the material arrives, the installer may need to finish another job before returning.

Meanwhile, work that depends on that installation may also need to be moved.

I have seen delayed decisions contribute to builds extending by three, four, or even six months. That does not mean every late selection causes that result. It means repeated delays, missed ordering deadlines, and disrupted trade schedules can add up to far more time than a homeowner expects.

How can changes during construction affect the completion date?

Changes during construction can affect the completion date when they add work, alter completed work, require new materials or approvals, or disrupt the planned trade sequence. The schedule impact depends on both the change and when it is made.

A walk-in attic is a good example from our own projects.

On roughly the last four or five homes we have worked on that included walk-in attic space, we discussed finishing that space before construction. Initially, the homeowners planned to use it strictly for storage. They did not see enough value in finishing it at that point.

Then we reached framing.

Once they could walk into the space, see its size, and picture how they might use it, the conversation changed. Now they wanted to go ahead and insulate it, install drywall, and provide heating and air conditioning.

I understand why that happens. Standing in a room can make its possibilities much clearer than looking at the same space on a drawing.

It can be a worthwhile change. But what began as unfinished storage has become additional finished space, and we have to account for everything that decision affects.

In that example, the floor system needs attention first. A floor designed for unfinished attic use is not automatically suitable for finished living space. The engineer needs to verify the design and determine whether modifications are necessary.

Both spaces have dead loads and live loads. Dead load is the weight of permanent construction, such as framing, drywall, and flooring. Live load includes people, furniture, and stored belongings. The intended use and added finishes affect the design requirements. The International Residential Code addresses these loads separately, and the applicable requirements must be checked for the project.

Then there is the additional insulation, drywall, heating and cooling, electrical work, and finish work to coordinate, along with any necessary plan revisions or approvals.

The attic is simply one example. Changing a layout, expanding the scope of a room, or revising a selection after related work has started can also affect the sequence. Some changes can be absorbed into the schedule. Others require additional time.

A change can be the right decision for the home and still change the completion date.

The important thing is to discuss the cost, affected work, and schedule together before proceeding. The original timeline was based on the original scope; when the work changes, we need to evaluate the timeline too.

Does a longer construction schedule cost the builder too?

A longer construction schedule costs the builder time and resources because an extended project continues to require supervision, coordination, site visits, and management time, even when a delayed decision limits the work that can proceed.

This is something homeowners do not always realize.

At Everett, we have every incentive to complete the home efficiently. Keeping a project open longer consumes time and resources on our side too.

When we ask for a selection, there is usually a practical reason behind the timing. We are thinking about the supplier, the installer, and the next stage of the house.

That does not mean every delay automatically produces an additional charge to the homeowner. It means the delay has real consequences for managing the project.

Our interests are aligned: finish the home correctly, with the work performed in the right order and without avoidable interruptions.

Are all construction delays caused by homeowner decisions?

Homeowner decisions are only one factor in construction delays. Weather, site conditions, inspections, supplier issues, trade availability, and builder coordination can also affect the schedule. Timely selections reduce one important source of avoidable delay.

Some construction delays are inevitable. Our goal is to eliminate as many as possible and manage the others responsibly.

In my experience, weather is probably the biggest source of delay until we get the house dried in. Dry-in is the stage when the roof and exterior enclosure provide protection from the weather. Reaching that stage reduces our exposure, although weather can still affect exterior work and site conditions afterward.

Trade coordination and availability are another major factor. We work with top-tier crews whose workmanship we know and trust. Even within a subcontractor’s company, I often have specific crews I want working on our homes.

Scheduling therefore means coordinating the right crew for the right stage of the house. Those crews have commitments to other projects too. If a delayed selection or material delivery causes us to miss their scheduled window, they may not be available immediately when we are ready again.

That is another reason early decisions matter. We cannot control the weather or every scheduling conflict, but we can work to have the information, materials, and preceding work ready when the crew is available.

A builder has a responsibility to explain what information is needed, provide reasonable deadlines, coordinate the work, and communicate when circumstances change.

Homeowners should not have to guess which decision is holding up which part of the house.

If a choice is difficult, discussing it early gives everyone more opportunity to resolve it. Sometimes we can settle the part that affects rough-ins while allowing more time for a finish. Other times, the entire selection must be approved before anything can be ordered.

The important thing is understanding the difference before the deadline passes.

What is the best way to help a custom home stay on schedule?

Make as many selections as possible before construction begins, finalize the remaining decisions by their agreed deadlines, and discuss scope changes with the builder before assuming the original completion date still applies.

My preference is still to select everything up front.

When that is not possible, we need a clear plan for what remains open and when it must be resolved. Homeowners also need to understand that approving a drawing, placing an order, receiving a product, and installing it are separate steps.

An item installed near the end of the project may need to be selected near the beginning.

That is why we spend so much time on decisions that may seem premature. We are preparing for the work that comes next.
